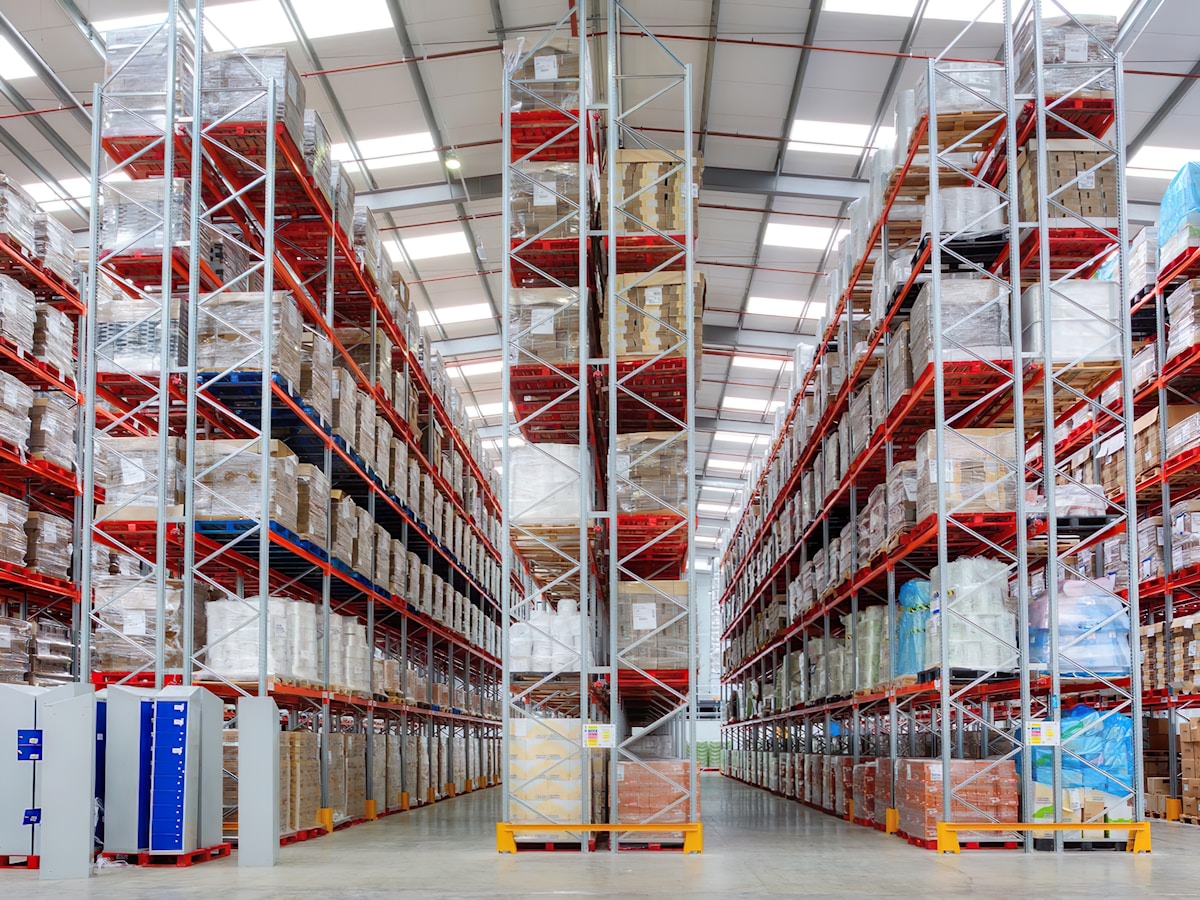

The racking becomes the building. Roof and walls attach directly to the rack structure, reaching heights conventional warehouses cannot.
This is not a racking order. It is a construction project where the storage system and the building are the same structure.
In a conventional warehouse you build a steel frame, then install racking inside it. In a rack supported building you skip the frame entirely. The rack uprights carry the roof and the wall cladding as well as the pallets, so you pay for one structure instead of two.
That is what unlocks the height. Freed from conventional roof spans, these buildings routinely reach well beyond typical warehouse clear height, which is why they are almost always paired with automated cranes or shuttles rather than forklifts. It also means very high storage density per acre of land.
The trade is permanence and process. The racking cannot be reconfigured later without touching the building, and the project runs under the Building Code with structural engineering, seismic and wind design, foundations, fire protection and a full permit process. Expect a long lead time and a design phase measured in months.
Every rack supported building is a bespoke construction project. These are typical characteristics, not a product spec.
| Specification | Typical Range |
|---|---|
| What It Is | Racking that carries the roof and walls as the building structure |
| Typical Height | Commonly 60 to 120 ft, well beyond conventional warehouses |
| Handling | Usually automated cranes or shuttles rather than forklifts |
| Storage Density | The highest available per acre of land |
| Flexibility | Very low. Reconfiguring means altering the building |
| Engineering | Structural, seismic, wind and snow loading, foundation design |
| Approvals | Full building permit, engineer-stamped drawings, fire review |
| Timeline | Design phase in months, not weeks. Long lead times on steel |
| Best Suited To | New build, high volume automated distribution, cold storage |
Figures are typical, not a specification. A rack supported building starts with land, throughput and automation strategy, so the first conversation is a planning one rather than a quote.
This is the largest and least flexible option on the site. It is the right answer for a small number of projects and the wrong one for most, and we will say which you are.
There is a narrow set of conditions where nothing else comes close.
Planning a new facility? Book a free consultation early. This is a decision made at site planning stage, not after the slab is poured.
For the overwhelming majority of operations, this is not the right answer.
Try drive-in or push back for density in an existing building, or a mezzanine to use height you already have.
No. The racking has to be the primary structure from the outset, carrying roof and wall loads with foundations designed for it. If you already have a building, the right conversation is about using the height you have with taller racking, a mezzanine, or a denser system inside the existing frame.
Commonly 60 to 120 ft, and taller has been built. The practical limits are the handling equipment, the fire protection strategy and local planning height restrictions rather than the steel. Height is exactly why these buildings exist, so the question is usually how tall your municipality will let you go.
At those heights forklifts stop being viable. Reach and cycle times fall away, and safety becomes difficult. Rack supported buildings are normally served by automated stacker cranes or shuttle systems running in fixed aisles, which is part of why the project is planned around throughput data rather than pallet counts.
Sometimes, because you fund one structure instead of two and use far less land for the same storage. But the engineering, approvals and automation are substantial, and the flexibility loss is permanent. It should be assessed as a whole project cost against land and operating savings, not compared to a racking quote.
Barely, and that is the honest headline. Altering the racking means altering the building, with the structural and permit work that implies. If your SKU profile or throughput is likely to change materially within a few years, a conventional building with a flexible system inside it will serve you better.
More practical routes to density in a building you already have.
